Explore our portfolio of completed projects, showcasing our expertise in quality construction, and timely delivery.
Our Clients
We’ve had the privilege of working with a range of incredible clients across various industries. Below are some of the projects we’ve delivered for them.
Our Projects
Project Summary
Project Length: 3 Months
Contract Value: $500,000
Contract Type: Schedule of Rates
TKD successfully executed fast-tracked civil works within an extremely compressed schedule to meet key project deadlines. The scope of works included:
Excavation and backfilling
Underground Services, Conduits and Drainage
In-situ concrete (FRP)

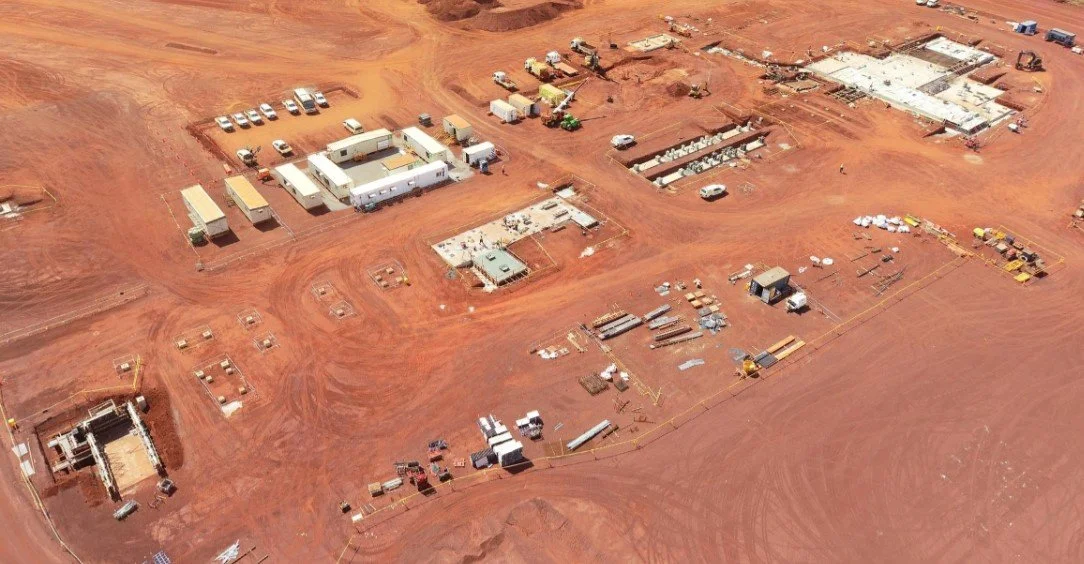

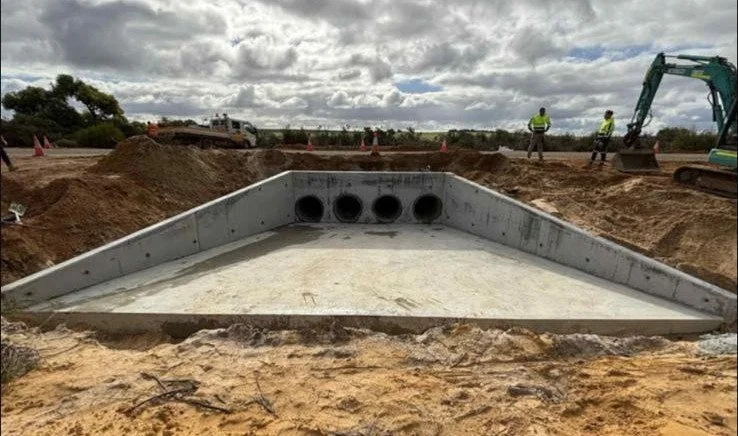

TKD and SRG Global delivered the construction of a new decant pond as part of the tailings infrastructure at Pilbara Minerals’ Pilgangoora operation. The project involved large-scale earthworks and containment works critical to supporting ongoing processing operations. The works were executed within an active mining environment, ensuring integration with existing tailings and water management systems.
PLS DECANT POND
Project Summary
Project Length: 6 Months
Contract Value: $700,000
Contract Type: Lump Sum

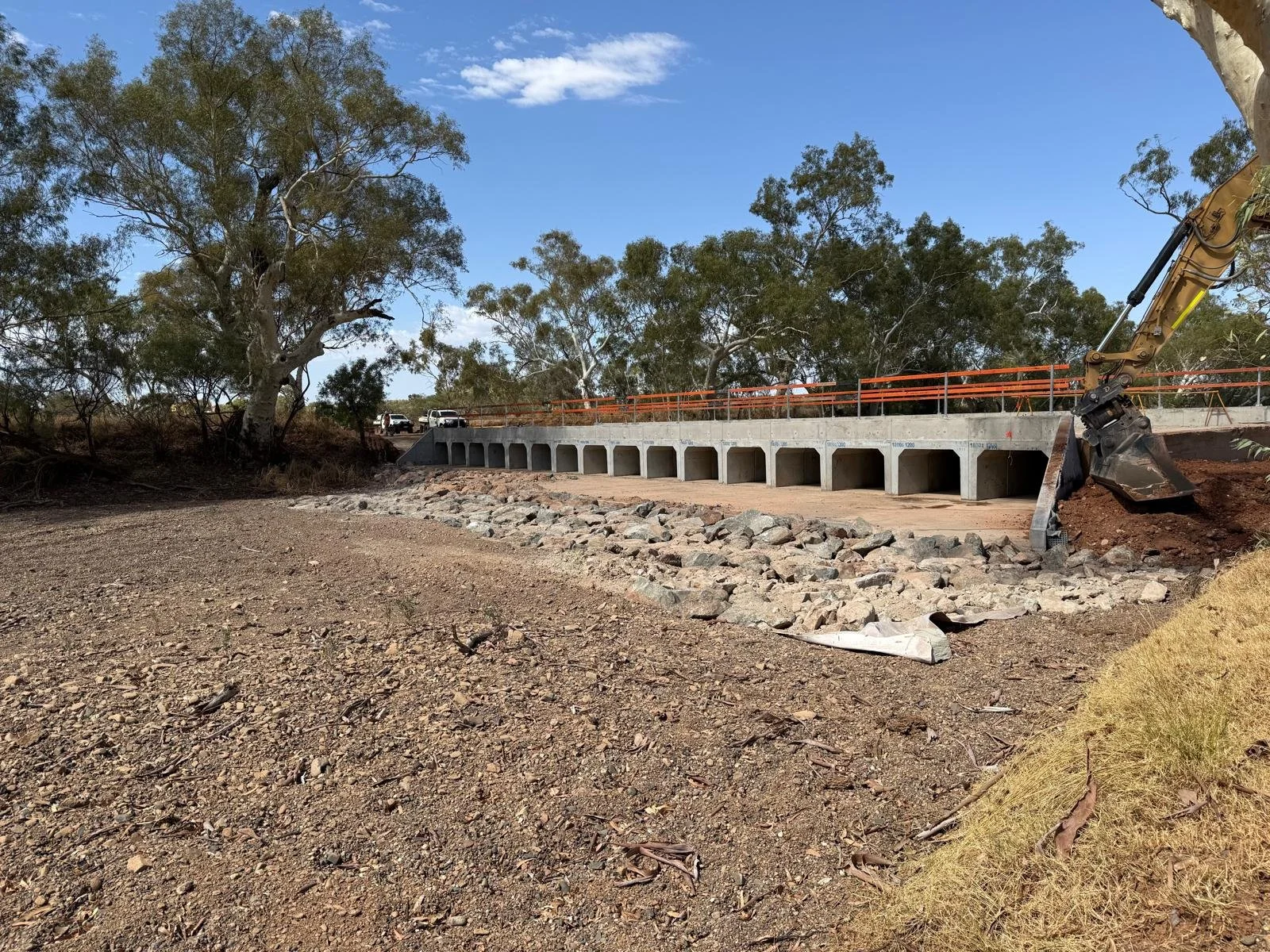

TKD delivered all FRP works for SRG, including significant culvert crossings at three critical-path locations.
Precast concrete install
In-situ concrete walls and slabs (FRP)

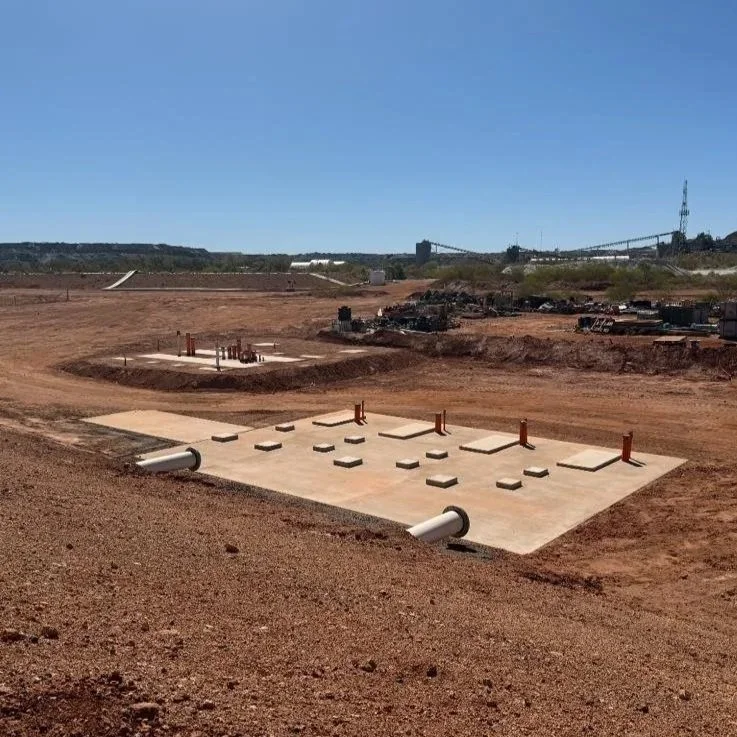

In 2025, SRG secured a substantial package of infrastructure contracts for HanRoy (Roy Hill mine) that includes minesite civil works associated with the Marble Bar Road upgrade. This scope covers construction of Sections 2A and 4, along with related civil infrastructure at the nearby McPhee Creek site. TKD completed all FRP works on the project.
HANROY MARBLE BAR ROAD
RED DUST HOLDINGS CIVILS PACKAGE
Project Summary
Project Length: 7 Months
Contract Value: $600,000
Contract Type: Schedule of Rates
TKD delivered several civils packages for RDH across 4 remote sites.
Precast concrete install
In-situ concrete walls and slabs (FRP)

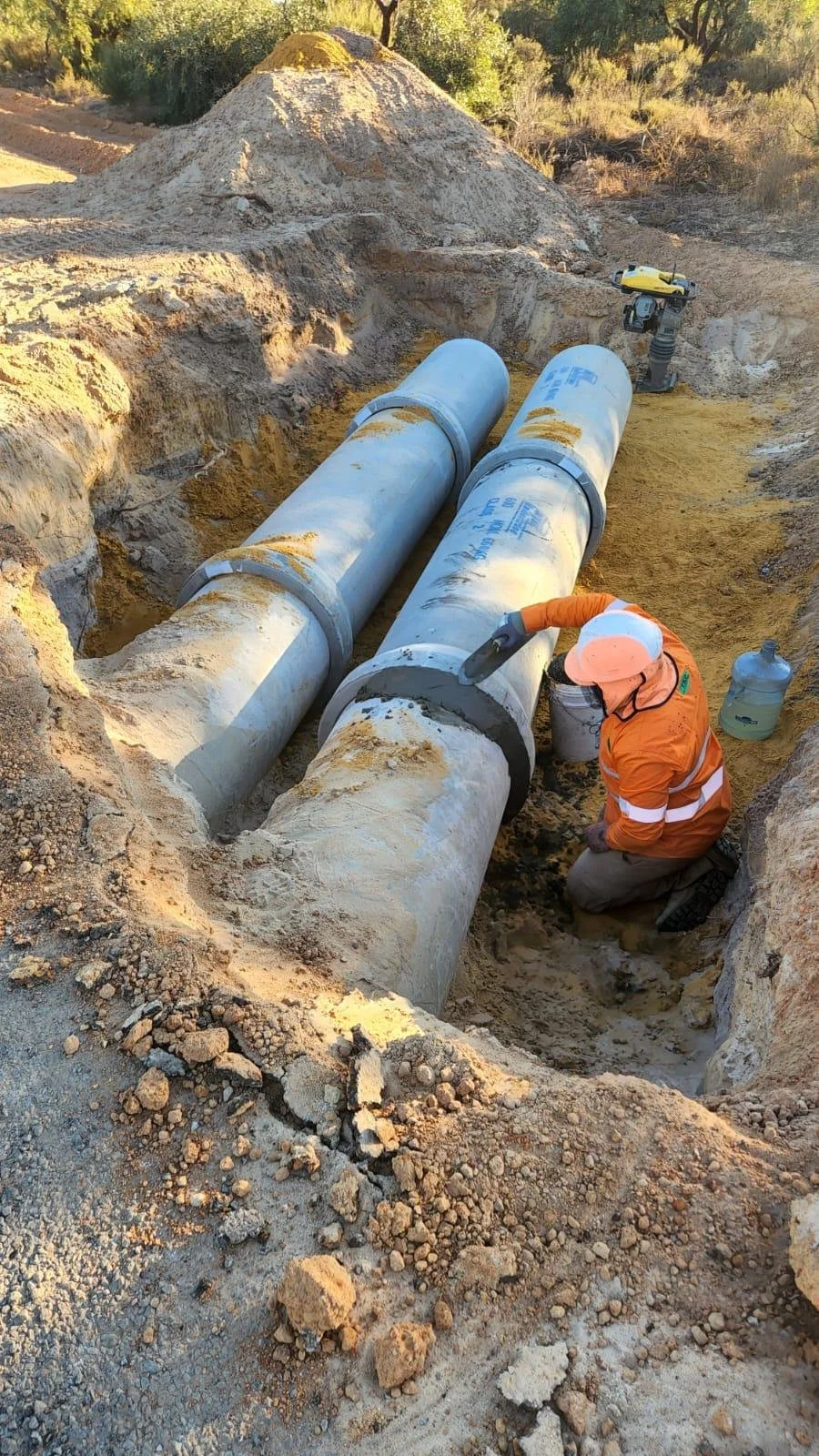

TKD successfully delivered remote civil works at 3 Springs, Geraldton, Eneabba and Riverina for RDH, requiring multiple mobilisations and demonstrating their ability to provide an agile workforce on demand. Their experience across these challenging regional projects highlights TKD’s reliability, versatility, and capacity to manage complex sites efficiently.
HANCOCK PORT INFRASTRUCUTRE
Project Summary
Project Length: 2 Months
Contract Value: $500,000
Contract Type: Lump Sum
TKD delivered several civils packages for Black Swan on Hancock’s Port Hedland Port Facility.
TKD delivered comprehensive civil works for Black Swan at Hancock’s Port Hedland facility, focusing on essential non-process infrastructure. The scope included construction and upgrades for the wash bay, maintenance domes, and other supporting civil structures, demonstrating TKD’s expertise in delivering high-quality, safe, and reliable infrastructure in a complex operational environment. Their work highlights the company’s capability to manage critical site requirements while maintaining operational continuity on a major resource port.
ALKIMOS SEAWATER DESALINATION PLANT
132Kv SWITCH YARD
Project Summary
Project Length: 4.5 Months
Contract Value: $350,000
Contract Type: Schedule of Rates
TKD executed fast-tracked structural works under a highly compressed schedule, working day and night shifts to meet project deadlines. Scope included:
Final trim and subgrade compaction
In-situ concrete (FRP), structural steel, and tilt-up panel installation
Conduits and drainage
Excavation and backfilling
The desalination plant in Alkimos will provide a safe, reliable, and cost-effective water supply. With less rainfall and a growing WA population, we’ll need 75–125 billion extra litres of water annually by 2035.
ALKIMOS SEAWATER DESALINATION PLANT

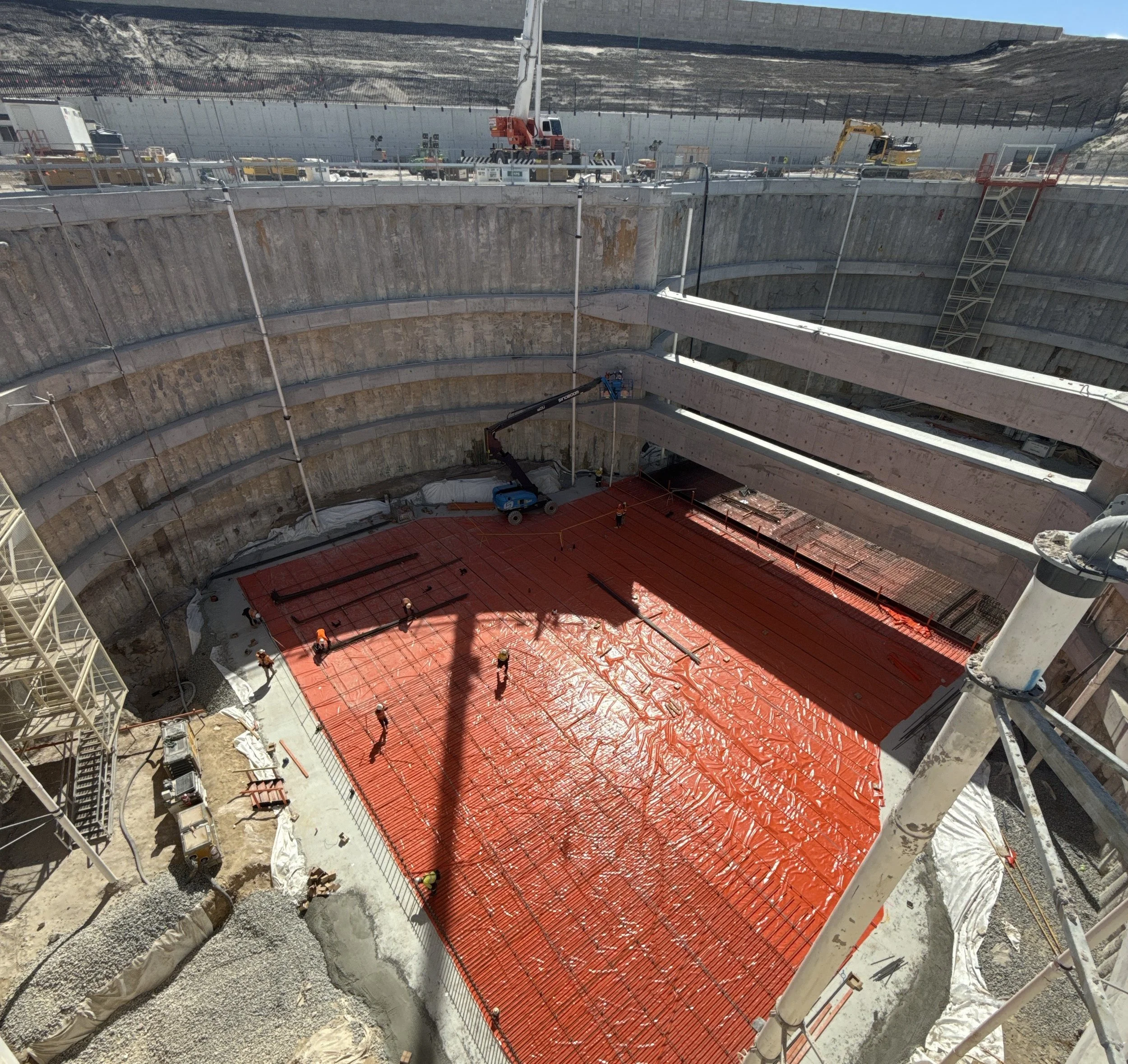

Secant Piled Peanut Shaft & Temporary Laydown Facilities
Project Summary
Project Length: 3 Months
Contract Value: $250,000
Contract Type: Schedule of Rates
TKD delivered essential early structural works for the SWIPS area and temporary facilities, including:
Capping beam, ring beams, base slabs, and buttress walls for the tunnel and pump shaft
Slabs for slurry treatment, tunnelling workshops, substations, dewatering, and grout plants
Gantry crane beams, footpaths, and associated site works
The desalination plant in Alkimos will provide a safe, reliable, and cost-effective water supply. With less rainfall and a growing WA population, we’ll need 75–125 billion extra litres of water annually by 2035.
BYFORD RAIL EXTENSION
Project Summary
Project Length: 7 Months
Contract Value: $600,000
Contract Type: Schedule of Rates
TKD delivered critical precast works, ensuring quality control, efficient team management, and strict adherence to safety and timelines. The scope of works encompassed the following:
Managed the pouring of 5,200m³ of concrete and installation of 2,900 tonnes of reinforcement steel.
Operated on a tight schedule with 5 pouring days per week (no weekend work).
Coordinated daily activities with a workforce of 80 people onsite, ensuring efficient execution.
Executed the casting, stripping, forming, and pouring of 13 beds daily, maintaining consistent productivity.
Deployed two 50-tonne gantry cranes for moving reinforcement steel, transporting cast planks to the wash bay, and facilitating load-outs to trucks
Project Summary
Project Length: 6 Months
Contract Value: $700,000
Contract Type: Lump Sum
TThe scope of works included the following key components:
Earthworks: Preparation of foundations, including loading, hauling, placement, and compaction of materials.
Concrete Works: Supply and installation of reinforced concrete structures for Conveyor CVR523, Crushing Station 5, transformers, switchrooms, and drive-in sumps.
Earthing: Installation and testing of earth grids, electrodes, and bonding systems to ensure proper grounding.
Miscellaneous Works: Installation of light pole footings, grouting of critical elements, construction of concrete stair pads, and installation of bollards.
This detailed execution plan was essential to delivering a robust and durable infrastructure aligned with project specifications.
ROY HILL ROM CRUSHER
ROY HILL FINES STACKER EXTENSION
Project Summary
Project Length: 2 Months
Contract Value: $300,000
Contract Type: Schedule of Rates
The project scope encompassed a range of critical activities, including:
Extending the stacker runways by 22 meters.
Constructing foundations (300m3) for buffer stops.
Fabricating and installing 5T steel buffer stops.
Removing a redundant bulk-in loading chute.
Extending tray supports to accommodate machine water hosing and electrical cabling.
Modifying existing services, including the installation of 100l/m new stockpile water cannon dia. 250mm HDPE.
Executing earthworks to excavate an additional 30 meters of fines stockpile canyon, with the base of the excavation lined with 500mm of coarse ore to facilitate drainage.
All works were completed in time for a planned total mine shut down with live connections and commissioning assistance provided by TKD during the shutdown.
These works were undertaken to enhance operational efficiency and support the project's overall objectives.
CHICHESTER TRANSMISSION LINE
Project Summary
Project Length: 8 Months
Contract Value: $1,200,000
Contract Type: Re-measurable

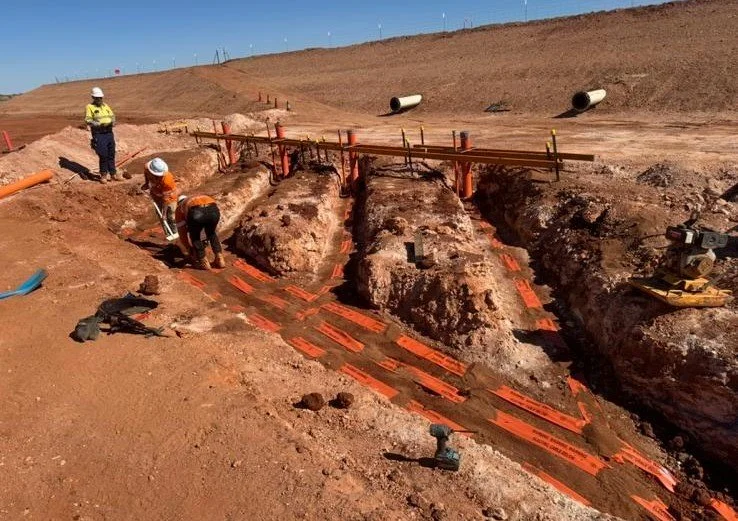

Transmission Line Extension: Construction of 60 kilometers (37 miles) of 220-kilovolt power transmission line.
Additional Power Lines: Installation of 3 kilometers (2 miles) of 33-kilovolt and 11-kilovolt lines to connect existing power stations to the network.
Solar Farm: Development of a 60-megawatt solar farm comprising two 30-megawatt single-axle solar arrays.
Substations: Construction of two substations to support power distribution.
Control Systems: Implementation of advanced control systems for seamless operation and integration of the infrastructure.
TKD successfully completed the construction of 136 lattice towers and 9 monopoles along the transmission line. Following this, TKD transitioned to work on the switchyard, where the team contributed to detailed earthworks and the formwork, reinforcement, and pouring of 1,100m³ of concrete.
Project Summary
Project Length: 7 Months
Contract Value: $800,000
Contract Type: Schedule of Rates
TKD was contracted by Westforce Construction to execute expansion works on the existing WHIMS plant. The scope of works encompassed the following:
Concrete Works: Placement of 3,000 m³ of concrete.
Bulk Earthworks: Foundation preparation, installation of culverts, and construction of access roads, totaling 12,000 m³ of earthworks.
Service Works: Removal of six light poles, including associated underground cabling. Installation of a firewater pipeline, hydrants, valves, and blind flanges.
External Works: Various external finishes, bollards, signs etc.
Drainage Works: Implementation of drainage systems.
Hydraulic Works: Hydraulic system-related activities.
This comprehensive scope reflects TKD’s commitment to delivering high-quality infrastructure solutions aligned with Roy Hill Iron Ore’s operational requirements.
ROY HILL ULTRAFINE IRON ONE
Project Summary
Project Length: 6 Months
Contract Value: $300,000
Contract Type: Schedule of Rates

TKD proudly contributed to the construction of the new Fitzroy Bridge in Western Australia, showcasing our diverse capabilities and commitment to delivering high-quality infrastructure.
Our involvement included:
Precast Concrete Production: Manufactured critical precast concrete components in Perth, ensuring precision, quality, and compliance with project specifications.
Onsite Labour and Installation Support: Deployed skilled teams to the construction site, providing expert support for the installation and assembly of the bridge structure.
